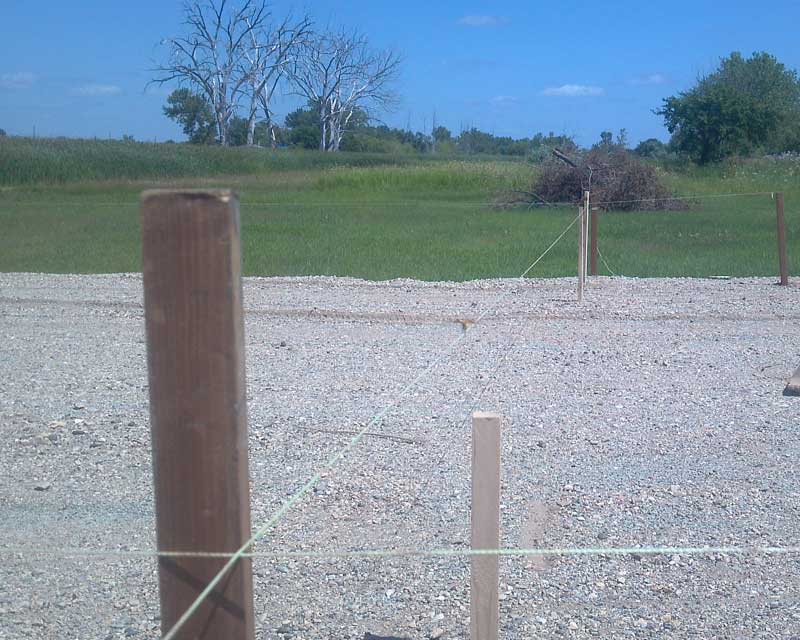

Building Site Preparation

I’m a Bit Confused…
No, not me – one of our clients who is about ready to invest in his new Hansen Pole Buildings’ Post Frame Building kit. Just like me, when I have something new on the way, Phil is chomping at the bit to be doing something! Anything!
DEAR POLE BARN GURU:  I’m trying to find a step-by-step guide in here somewhere. 🙂
I’m clearing off the topsoil next week, and I plan on digging the post holes soon after. Two questions: What should the diameter of the holes be? Do I lay out the gravel foundation before I do that? I’m a bit confused. (VIDEOS would be great!) Thanks PHIL in LOUDON

DEAR PHIL: After your order is placed, you will have immediate access to the online version of the Hansen Pole Buildings’ Construction Manual. You will also receive a printed copy of it in the mail, soon thereafter. In the meantime, here is an excerpt from Chapter 2 which should help with your site preparation:
BUILDING SITE:
To allow proper drainage plan to keep building grade higher than surrounding site. On an ideal site, water drains naturally away from building. Since few sites are ideal, in most cases, grade work will be required to keep surface water away from building. Keeping finished building floor higher than the surrounding site reduces flooding chances during heavy rainfall or rapid snowmelt.
In flood plains, consult first with your building department to determine their requirements. Typical recommendation is to establish grade level at finished floor top higher than flood level. This may require importing fill to raise grade. A surveyor can be hired to expertly determine these heights. In some cases, vents may be installed, below flood level, to equalize interior and exterior pressures,
Many sites can be graded with a skid steer (a.k.a. Bobcat) or backhoe. Some cases will require heavy equipment to properly grade site to allow water to drain away from building. If a professional is engaged for site grading, make certain finished grade prepared is adequate before making final payment. In far too many cases “flat” sites which are out of level have been experienced by disappointed owners.



At a minimum, site preparation includes:
· Remove all sod and vegetation.
· For ideal site preparation, remove topsoil and stockpile for later use in finish grading. In frost prone areas, remove any clays or silty soil
from within the future building “footprint”.
· Replace subsoil removed from around building with granulated fill to help drain subsurface water from building.
· Distribute all fill, large debris free (no pit run), uniformly around site in layers no deeper than six inches.
· Compact each layer to a minimum 90% of a Modified Proctor Density before next layer is added. Usually, adequate compaction takes more than driving over fill with a dump truck, or
earth moving equipment.
· When any building portion sits on fill, rest columns, as well as any concrete encasement, on or in undisturbed soil. In many cases, building inspectors will require a soils engineer to
confirm compaction adequacy on filled sites. Soils engineers can be expensive, but are even more costly when called in to do analysis “after the fact”. Our Building Engineers are
unable to visit sites, therefore they cannot perform or provide any soils or other similar reports, design retaining walls or any other work beyond the building shell.
Be certain to know local Building Department requirements before starting to move dirt.
In many jurisdictions, a separate grading permit may be required. In some cases soil may not be allowed to be moved until after a building permit has been issued. Get started on the right foot with permit authorities – ask first before digging!
Also, prior to doing any excavation call 811. This is a free service to mark underground utilities. Property owners and contractors can be held financially liable if they fail to locate underground utilities (like gas, electric, telephone, cable, water) and damage them in any way (not to mention potential for severe injury or death).
Grade actual building “footprint” area as level as reasonably possible. A grade change beyond eight inches will often result in having to acquire longer building posts.
Grade change is ideally checked before placing building order, however this is not often feasible as a practical matter. If grade has not been checked before order placement, do so within 24 hours. Longer posts are far more economical when provided with original lumber delivery. In some instances, building posts have been specially ordered (due to dimension, length, treating specifications or a combination) and cannot be returned to original producer for credit, even if they have not yet been delivered to jobsite.
Create an adequate work area. At a minimum clear at least five feet beyond each building side. Grade the area beyond building perimeter away from building with a 1% to 5% slope to drain surface water away in all directions. A 5% slope is a 3 inches drop in 5 feet.
I would encourage you to do all site preparation, other than the final layer of compactable rock which will be directly below your concrete floor, prior to digging holes.

In the week or so following your order placement, your building plans will be drafted. You will receive a pdf version through your on line login to our website, which will include a page with all of the column locations as well as diameter of the holes. You will be able to print this, in advance of receipt of your engineered plans via mail. In the case of your particular building (subject to final engineering review), it appears all structural (roof supporting) column holes will be 40 inches in depth. The double truss bearing column holes along the eave sides will need to be 24 inch diameter, while the balance will be 18 inch diameter.
Have fun, Phil!

Moby Dick Was Not the Great White Swale

Call me Ishmael.

WhaleSome years ago—never mind how long precisely—having little or no money in my purse, and nothing particular to interest me on shore, I thought I would sail about a little and see the watery part of the world. It is a way I have of driving off the spleen and regulating the circulation.

Opening line of Moby Dick, Herman Melville, 1851

Swale, whale….what difference does a few letters make? Well, if they involve the area around a new commercial pole building requiring swales, it could amount to a whale of a cost!

What is a “swale” anyway?

Grassed infiltration swales (“swales”) are depressions (collection areas) in which storm water from roofs, streets and driveways is collected following a rain or snow event. Swales are used to collect and dispose of storm water runoff, and to remove pollutants from storm water before it reaches underground sources of drinking water. Within a swale there is typically an elevated grate (four to six inches above grade) which is the cover for a drywell. The drywell receives overflow from the swale in the event of excessive runoff. Storm water enters swales through cuts in the curb or through catch basins and infiltrates through the grass and soil. Pollutants in the storm water are removed by the grass and soil in this infiltration process, helping to protect ground water sources from contamination.

Why is a swale necessary?

Drainage swales rely on the infiltration process, which is when water “soaks” into the ground and eventually recharges groundwater. The infiltration process requires the soil to have pore spaces for the water to pass through. Some ground materials have larger pore spaces than others, for example gravel is very effective for allowing water to pass through. Clay soils have small pore spaces which limit the amount of water which can pass through.

Requirements vary from jurisdiction to jurisdiction, however this overview gives an idea of what is entailed.

How do you design a swale?

The depth from the swale floor to the top of drywell grate must be no more than 8 inches, but deep enough to accommodate the designed volume of runoff. Following a storm event the swale should not have standing water for more than 72 hours. The floor of the swale should be level to evenly distribute water throughout the swale. The drywell should not be placed near the inlet to the swale. Drywells should be installed according to the approved plans.

Developing a good swale

Do not drive over swale area prior to construction. Compaction of soils will dramatically reduce infiltration. Shallow bedrock under the swale area will prevent percolation and infiltration, significantly reducing the performance of the swale. Importing top soil or sand will create a layered subsurface which is not conducive to good infiltration. Onsite top soil should be used in swales whenever possible. When off-site top soil/sand is used it should be mixed with two inches of organic matter per six inches of top soil and rototilled into the existing surface. This will greatly increase the infiltration capacity of the swale. Do not clean concrete truck chutes, masonry tools, and painting equipment in or near swales. These materials will dry and produce a layer of impermeable material which can destroy the infiltration process.

Sod is not the only option for establishing grass in swales. Hydroseeding is becoming more and more accepted. Recommendations for seed mixes are moving to grass species which are able to establish in poor soils and have a high drought tolerance. For aesthetic purposes, drought tolerant species are being utilized in areas which do not require turf. Sod should be fresh and after being placed should be kept damp for 2-3 weeks to encourage rooting.

How to protect a swale

 Erosion on construction sites occurs when cleared and graded slopes are not protected from the erosive forces of rain fall and runoff. Frequently, there are no measures taken to protect infiltration swales from the deposition of the sediments in runoff. This results in a fine layer of silt that clogs the bottom of the swale. Slopes which have been graded must be protected from erosion. Inlets to the swale should be protected from runoff carrying silt eroded form the site.

Drywells in the swale should be protected from sedimentation by placing filter fabric under the grate.

Pole Barn Guru’s Swale Experience

 My first personal swale adventure was when I developed about three acres of land and constructed an 80’x150’ pole building for fabricating roof trusses. Most of the property was covered by either the building, or paved areas for parking and lumber storage.  The engineered site plan was deemed necessary to account for a great deal of storm water runoff. The required swales were so large, I was sure we could have floated the Pequod in at least the largest of them!  The soil was so sandy, I was personally sure if you dumped a cup of water on the ground prior to the installation of the swales, it would have been in the aquifer in an hour. However, bound by the planning department, I had no choice.

And for their cost, I could have bought a replica of the Pequod – between the engineering, the excavator, drywells, special soils and sodding….everyone had their hand out.
